The governing issue is no longer how efficiently a company records completed activity. It is whether the economic meaning of that activity remains intact while the work is still moving.
A completed task should not later become a puzzle assembled for billing. It should already carry the customer, project, person, duration, cost, rate, progress, materials, responsibility, and contractual conditions that give the work economic meaning.
More value now lives in execution than the shipment reveals
For much of industrial history, the visible unit of value was an object that could be produced, stored, counted, and shipped. That model still matters. Yet it no longer describes the whole result, even inside a manufacturing company. Design, configuration, installation, maintenance, project control, response time, and technical support can determine whether the physical product creates the expected return.
The economic shift is measurable. Services increased from 53 percent of global GDP in 1970 to 67 percent in 2021. Trade in services also rose from 7.6 percent of GDP in 1990 to 13.4 percent in 2022, according to the [OECD analysis of services trade](https://www.oecd.org/en/publications/revitalising-services-trade-for-global-growth_3cc371ac-en/full-report/component-2.html). More importantly for industrial leaders, OECD Trade in Value Added indicators show that services account for more than 30 percent of the value added in exports of manufactured goods.
This does not mean the intangible has displaced the tangible. It means value increasingly depends on what people execute around, through, and after the object. A construction contract, a maintenance intervention, a financial document, a custom production order, and a consulting deliverable differ in substance. Managerially, they share a condition: time, competence, responsibility, and evidence must become an economic result.
That condition changes the design question. If work produces value, planning, execution, and billing cannot remain separate interpretations of the same event. They need continuity.
Fragmented records hide margin while there is still time to protect it
Consider an ordinary operating scene. A technician completes an intervention at a customer site. The activity is closed locally, hours are entered later, materials are reported elsewhere, and the applicable rate sits in a contract or financial system. Someone must reconcile those facts before an invoice can be issued. Each fact may be accurate. The break occurs in the connections between them.
The same pattern appears in office projects. A project manager reports progress in one application, the team records time in another, finance obtains costs from the ERP, and customer commitments remain in the CRM or contract archive. At the status meeting, people reconstruct what happened and compare it with what they expected to happen. The meeting becomes a temporary integration layer.
This is not merely administrative inconvenience. Late time entries can leave completed work unbilled. Duplicated information creates competing versions of progress. A margin reviewed after closing may be numerically correct but managerially useless, because the overload, delay, or pricing mismatch that consumed it can no longer be changed.
The prevalence of multiple tool categories makes this operating reality visible. In PMI's 2023 global survey of 2,588 project professionals and leaders, 83 percent reported using document management software always or often, 81 percent collaboration tools, 75 percent budgeting or financial tools, and 66 percent project management software. ERP, analytics, reporting, and time tracking tools also appeared in the same survey. The categories overlap, so they must not be added together. Their significance is different: project work commonly crosses several information environments. See the [PMI Pulse of the Profession 2024 report](https://www.pmi.org/-/media/pmi/documents/public/pdf/learning/thought-leadership/pmi-pulse-of-the-profession-2024-report.pdf).

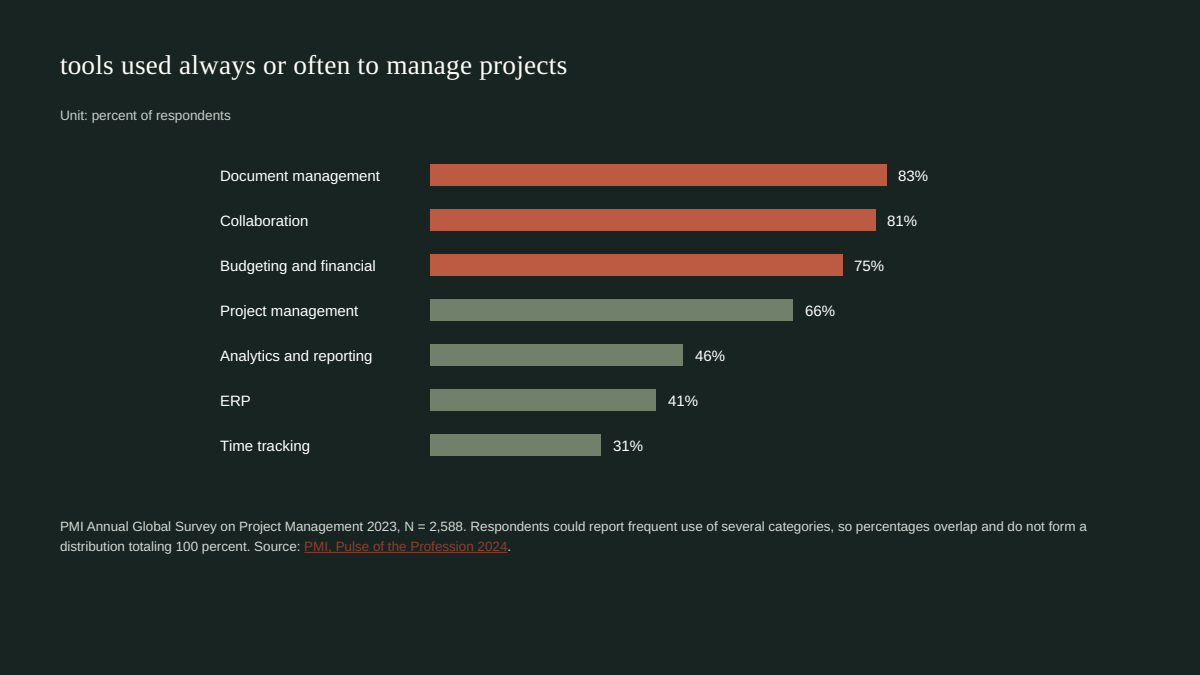

tools used always or often to manage projects

Unit: percent of respondents
| Tool category | Respondents |
|---|---|
| Document management | 83% |
| Collaboration | 81% |
| Budgeting and financial | 75% |
| Project management | 66% |
| Analytics and reporting | 46% |
| ERP | 41% |
| Time tracking | 31% |
Field work makes the continuity problem easy to see because connectivity cannot be assumed. A mobile application that records activities and hours offline, then synchronizes automatically, can preserve the information created on a construction site, at a plant, or in a customer facility. The principle extends well beyond the field. Office projects, professional services, custom manufacturing, internal activities, installations, and document based services all need the completed action to retain its operational and economic context.
AI needs the chain of consequence, not a seat beside the application
Only after that continuity exists does AI become a serious management instrument. A model cannot reliably interpret project health if capacity is in one system, skills in another, hours arrive late, and financial consequences are calculated after the operating facts have been detached from their source.
Inside governed context, AI can compare planned capacity with actual workloads, examine progress against historical patterns, identify anomalies across projects, and signal when cost or time is moving away from the assumptions behind a margin. Its role is not to decorate an application with conversation. It is to interpret the relationship among plan, action, and consequence while managers can still intervene.
This also sets a boundary. AI should not replace contractual rules, permissions, approved rates, or proven business logic with probabilistic improvisation. It should operate within them. The more consequential the recommendation, the more important it is that people can trace the data, rule, and operating event behind it.
The strategic question begins before the invoice
The decisive issue is not whether every organization uses one application. It is whether the company can follow the economic meaning of work without repeatedly reconstructing it. Integration may connect systems, but management continuity requires shared definitions, timely events, governed responsibilities, and a visible relationship between progress and margin.
If competence, time, responsibility, responsiveness, and quality of execution now carry as much weight as physical output, can a company continue governing that value through separate systems that reconstruct it only after it has been produced?
The useful reflection for any leadership team is therefore concrete: has the intangible side of the business already reached the same weight as the tangible side, while its operating model still treats it as secondary?
